MIC (Modular Integrated Construction): When It Works—and When It Doesn’t

February 10, 2026

Modular Integrated Construction (MiC / MIC) is a construction method where free-standing volumetric modules—often completed with structure, MEP, finishes, fixtures, and fittings—are manufactured in a controlled factory environment, then transported and installed on-site.

MIC can deliver real schedule and quality advantages—but it’s not a universal solution. The best results come from choosing MIC for the right project, and committing to MIC early enough to design for manufacturing and installation.

This guide explains where MIC shines, where it struggles, and how to assess feasibility without guesswork.

When MIC Works Best

1) Repetition and Standardization

MIC performs best when the design includes:

  • Repeatable unit layouts (e.g., stacked bathrooms, repeated room types)
  • Consistent module sizes and interfaces
  • Limited bespoke geometry

Why: modular efficiency comes from repeating proven details and production steps.

2) Tight Schedules (When Early Decisions Are Possible)

Modular projects can gain time because factory work and site work happen in parallel—while foundations and site prep progress, modules can be produced offsite. Industry reporting commonly cites meaningful schedule improvements when modular planning is executed properly.

3) High QA / Controlled Conditions

Factory environments reduce weather exposure and enable standardized processes and inspections, improving consistency—especially for complex MEP coordination.

4) Projects With Predictable Interiors

Good-fit examples often include:

  • Multi-residential components with repeatable units
  • Hotels (repeatable rooms)
  • Student housing
  • Remote / constrained sites (depending on logistics)

When MIC Usually Struggles

1) Late Design Changes

MIC is unforgiving to late scope shifts. The more you “freeze” the design early, the better it performs. Research on modular adoption notes that modular can require more detailed design earlier than conventional builds.

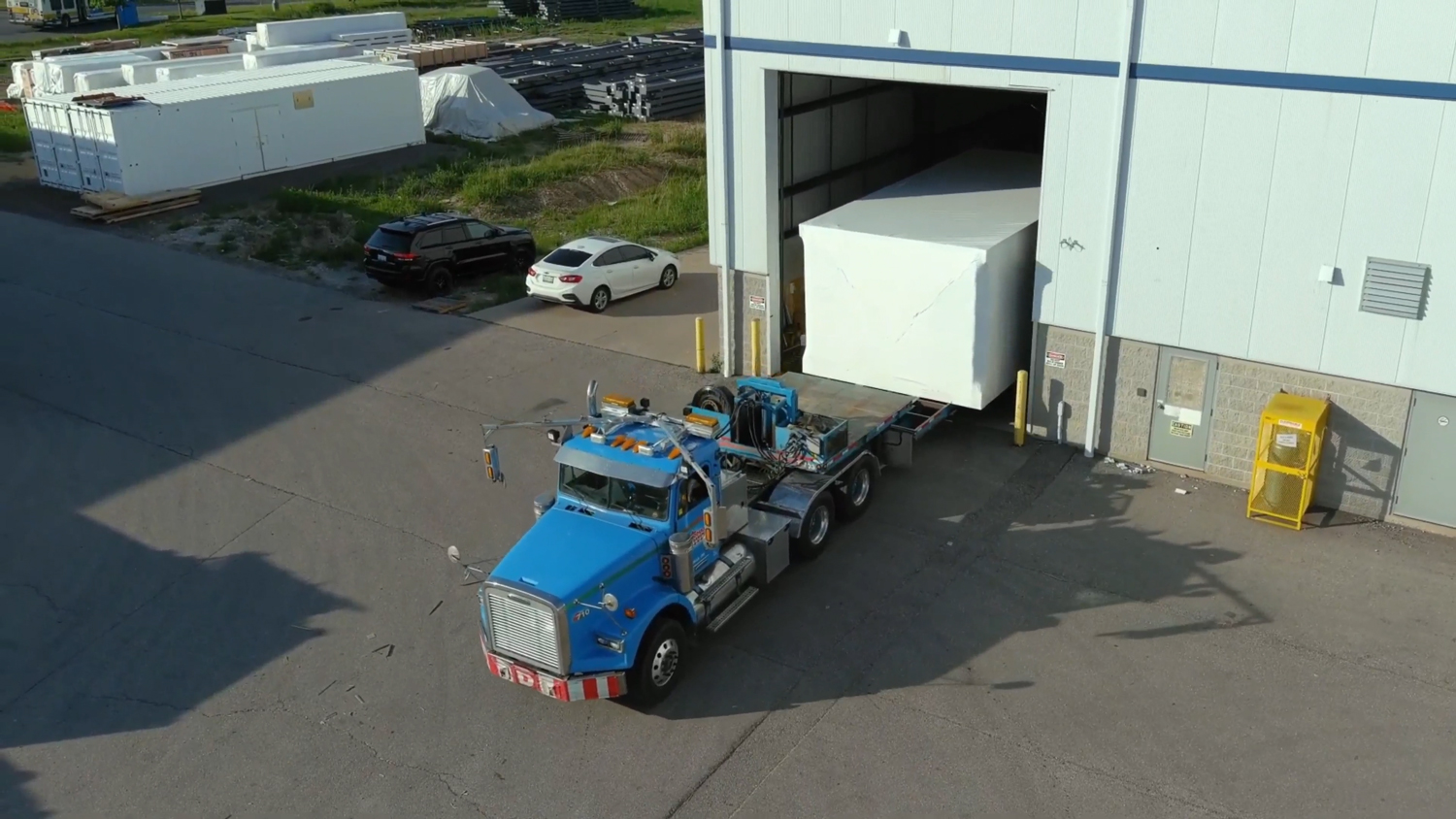

2) Severe Transport and Crane Constraints

MIC requires realistic planning for:

  • Module dimensions and route restrictions
  • Permits and delivery windows
  • Crane positioning, lifts, and staging

If the site cannot support safe, efficient installation, MIC loses its advantage quickly.

3) Highly Custom One-Off Architecture

Homes or buildings with constantly changing geometry, unique structural moves, or highly bespoke detailing can push MIC toward higher cost and risk—unless you intentionally modularize only certain portions (e.g., bathroom pods).

4) Weak Supply Chain Alignment

MIC success depends on reliable manufacturer capacity, QA documentation, and coordination across design–factory–site. Without this, project risk can increase rather than decrease.

Code Compliance and Certification in Canada

In Canada, modular/factory-built construction is commonly supported through CSA A277 certification, which is a framework for certification programs for prefabricated buildings, modules, and panels.

Ontario’s building code references CSA A277 procedures for factory certification, while still requiring code compliance for site installation and applicable requirements.

Practical takeaway: MIC can be code-compliant and robust—but it must be structured around the right certification pathway and documentation plan from the start.

The MIC Delivery Roadmap (What a “Good” Process Looks Like)

Phase 1 — Feasibility (2–6 weeks)
  • Define module strategy (what’s modular, what stays site-built)
  • Set dimensional rules (module widths/heights, transport limits, stacking logic)
  • Identify early risk items: fire/life-safety strategy, acoustic targets, envelope interfaces, crane/staging plan
Phase 2 — Design for Manufacturing & Assembly (DFMA) (6–12+ weeks)
  • Freeze layouts earlier than conventional builds
  • Engineer connections, tolerances, and interface details
  • Lock MEP routing zones and penetration strategies
Phase 3 — Factory Partnering & QA Plan
  • Confirm certification pathway (e.g., CSA A277 approach)
  • Establish inspection points, documentation, and sign-offs
  • Align procurement schedule (long-lead equipment inside modules)
Phase 4 — Parallel Work: Site + Factory
  • Site: foundations, services, craning plan, temporary works
  • Factory: module fabrication, MEP integration, finishes, pre-testing where applicable
Phase 5 — Logistics, Installation, and Commissioning
  • Delivery sequencing (just-in-time if staging is limited)
  • Crane lifts and set sequence
  • Final connections, testing, commissioning, and close-out documentation

Common MIC Risk Points (And How to Reduce Them)

  • Interface detailing (module-to-module + module-to-site-built areas) → Solve early with standardized details and tolerance strategy.
  • MEP coordination and access → Define service zones and access panels early; test maintainability.
  • Acoustic / fire strategy → Confirm assembly requirements before production, not after.
  • Schedule illusion → MIC saves time when decisions are early; otherwise it can shift schedule risk upstream.

Canada-focused research also highlights broader industrialized construction opportunities—and barriers like regulatory inconsistencies and procurement challenges—so planning and alignment matter.

FAQ

Is MIC always faster?
It can be, because site and factory work can run in parallel—but only if design decisions and procurement are locked early.

What’s the biggest difference vs. traditional construction?
MIC requires earlier design finalization, more interface detailing, and a logistics-first mindset.

How do I know MIC can meet code requirements in Canada?
Factory-built modular projects often rely on CSA A277 certification pathways and required documentation, while still meeting applicable code requirements at the installation site.
